Complete Guide to Oversized & Overweight Permits in the USA

Navigating oversized and overweight permits can be a complex and costly challenge for fleet managers, owner-operators, and logistics professionals across the USA. Each state has rules, regulations, and permit requirements that must be carefully understood to avoid fines, delays, and costly compliance issues.

This guide is your all-in-one resource to simplify the permitting process and provide up-to-date state-by-state information you can trust.

Whether transporting a wide load, heavy equipment, or specialized cargo, this guide offers clear explanations, practical tips, and essential details to help you confidently plan your route.

Everything you need for compliant and efficient heavy haul shipments, from permit types and escort vehicle rules to key safety requirements and planning strategies. Dive in to make sure your next oversized move goes smoothly and safely.

Oversized & Overweight Permit Fundamentals

Understanding the fundamentals of oversized and overweight permits is essential for anyone transporting large or heavy freight across the United States.

While the federal government sets baseline size and weight limits for vehicles operating on the National Network of highways, it does not issue permits for oversized or overweight loads. This responsibility falls to individual states.

Each state establishes its own permitting rules and processes, making it critical to know these fundamentals for safe and compliant heavy haul operations. States increasingly use advanced permitting systems, including automated platforms, to improve permit accuracy, processing speed, and route safety.

Divisible vs. Nondivisible Loads

A crucial concept in oversized and overweight permitting is the distinction between divisible and non-divisible loads.

This differentiation affects whether or not a permit is required and ensures that permits are only granted when necessary to protect infrastructure and public safety. Understanding this distinction helps carriers plan appropriately and avoid costly compliance errors.

Nondivisible loads are single units of cargo that cannot be separated into smaller pieces without causing damage or loss of value.

Examples include:

  • Large industrial machinery
  • Construction cranes
  • Prefabricated bridge beams

As per the Federal Highway Administration (FHWA) Oversize/Overweight Permit Guidance, because these loads exceed legal size or weight limits in their entirety and cannot be legally broken down, they require special permits for transport.

Divisible loads, in contrast, consist of cargo that can be broken down into smaller units or packages without harming the goods or reducing their commercial value.

Examples include:

  • Pallets of materials
  • Bundles of lumber
  • Coils of steel

Such loads do not need oversized or overweight permits as they can be split and transported as legally sized and weighted shipments. The FHWA guidelines emphasize that divisible cargo must be broken down and transported separately to comply with standard vehicle regulations.

Federal Size & Weight Limits

While individual states have the authority to set their own rules on non-federal roads, the federal regulations serve as the foundation for maximum allowable dimensions and weight for vehicles on interstate and designated highways.

According to the Federal Highway Administration (FHWA), the key federal limits include:

 Dimension/WeightFederal Limit
semi truck gross weight limit 80,000 poundsGross Vehicle Weight80,000 pounds
single axle truck weight limit 20,000 poundsSingle Axle Weight20,000 pounds
tandem axle weight limit 34,000 poundsTandem Axle Weight34,000 pounds

Federal size and weight limits set baseline standards for commercial vehicles operating on the National Network of highways in the United States. These limits protect highway infrastructure, ensure road safety, and promote uniformity across state lines.

Transport Coordination Requirements

Transport companies and shippers moving oversized and overweight loads must meet critical coordination and compliance requirements to operate legally and safely.

Business Registration and Compliance

The motor carrier must be properly registered as per state and federal regulations.

For example, in Utah, vehicles must be registered per state codes, and the motor carrier must fulfill financial responsibility obligations under federal regulations, including Unified Carrier Registration (UCR) and Hazardous Material Regulations when applicable.

This registration ensures accountability and legal authorization for heavy transport operations.

Driver Qualifications and Licensing

Drivers operating oversized or overweight vehicles must have appropriate licenses with endorsements specific to commercial heavy haul operations. This includes compliance with the Federal Motor Carrier Safety Regulations (FMCSR).

Properly licensed and trained drivers are essential for managing the complexities of transporting large loads safely on public roads.

To obtain a CDL, candidates must pass written knowledge and practical skills tests tailored to commercial vehicle operation, including specialized endorsements for hauling hazardous materials, tank vehicles, or passenger transport.

Licensing classifications depend on the Gross Vehicle Weight Rating (GVWR) and the type of vehicle combination. Here are the different classes of CDL:

ClassVehicle TypeCriteria
Class ACombination vehiclesGCWR ≥ 26,001 lb and trailer > 10,000 lb
Class BSingle vehiclesGVWR ≥ 26,001 lb, or if towing, trailer < 10,000 lb
Class CPassenger or hazmat vehiclesDesigned to carry 16+ passengers or transport hazardous materials requiring placarding

Permit Acquisition and Route Coordination

Before movement, transporters must obtain the correct oversize/overweight permits for their load. Permit applications require detailed vehicle, load, and route information to be submitted to the permitting agency.

Many states provide online permitting systems for efficiency. Transport companies must coordinate closely with state departments of transportation to plan routes that consider infrastructure limits, clearances, and safety requirements.

Communication and Documentation

Loads must carry permits physically or electronically during transport for law enforcement inspections. Continuous communication between the driver, escort vehicles, and carrier dispatch is often mandated to ensure coordination on the route, especially when navigating constraints or escort requirements.

Liability and Indemnity

Permit holders assume full responsibility for damages or injuries caused during transport operations. They must comply with indemnity clauses protecting state agencies from claims arising from oversized load movement.

This legal framework emphasizes the seriousness of compliance and risk management in heavy haul operations.

Escort & Safety Vehicle Requirements

Escort or pilot vehicles are essential for safely transporting oversized and overweight loads. Their primary role is to alert other road users to wide or heavy vehicles, assist the truck driver in navigating complex or constrained routes, and help ensure compliance with permit conditions.

Generally, a front escort is required for width, and a rear escort for length, with many states mandating escorts for loads over 12 feet in width.

Oversized Load Escorts Rules

Oversized or large trucks are medium or heavy‑duty vehicles with a gross vehicle weight rating above 10,000 pounds. This category excludes buses and motor homes but includes commercial and non‑commercial trucks. Within this group, 5,375 trucks were involved in fatal crashes, 8.4 % fewer than the prior year, yet still 43% higher than the total from a decade earlier.

To help keep the public safe when extra‑legal vehicles or loads are on the road, a certified pilot or escort operator must accompany them whenever specific criteria are met.

The following sections outline the conditions that trigger the need for an escort vehicle.

Trigger/ConditionHighway typeEscort requirement/position

Width > 11 ftTwo‑laneTwo escorts: 1 front + 1 rear
Width > 14 ftMulti‑laneOne escort: rear
Width > 20 ftMulti‑lane undividedTwo escorts: 1 front + 1 rear
Tractor/trailer total length > 105 ft or rear overhang > 1/3 of trailer lengthTwo‑laneOne escort: rear
Trailer length (incl. load) > 125 ftMulti‑laneOne escort: rear
Front overhang > 20 ft (from center of front steer axle)Two‑laneOne escort: front
Single‑unit vehicle rear overhang > 20 ft (from center of rear axle)Two‑laneOne escort: rear
Height > 14 ft 6 inAll highwaysOne escort: front with a height pole
Width > 12 ft on multi‑lane AND a front escort is required for heightMulti‑laneAn additional rear escort is also required
The driver cannot see ≥200 ft behind using mirrorsAll highwaysOne escort: rear
Department deems an escort necessary for public safety (unique circumstances)As directedEscort(s) as authorized by the administrator

Types of Escorts and Their Roles in a Convoy

Different situations call for various types of escorts, each playing a distinct role in the convoy. These roles are critical for ensuring safe and compliant transport.

Escort CategoryTypical DeploymentPrimary Responsibilities
Pilot Car (Front)Ahead of oversized loads, narrow or two‑lane routesWarn oncoming traffic; check clearances with the height pole; display signs/lights
Chase Car (Rear)Behind the loadAlert trailing traffic; assist with lanes/turns; keep buffer; brief traffic holds
Police EscortSuperloads; dense urban or high‑risk corridorsTraffic control; manage intersections/closures; enforce permit conditions
High Pole EscortFor tall or overheight loads requiring overhead clearance verificationLead the load to measure and verify vertical clearances; communicate obstructions; prevent overhead strikes
Specialty EscortsExtreme height or utility conflictsLift/move lines; confirm vertical clearance; prevent overhead strikes

All escort vehicles must be appropriately certified and equipped with standardized signage, flashing amber lights, and communication devices (CB radios) to maintain continuous contact with the truck driver.

These requirements ensure that escorts can effectively warn the public and coordinate with each other to support safe and compliant oversized load movement across jurisdictions.

Route Planning for Wide & Heavy Loads

Effective route planning is essential for the safe, legal, and efficient transportation of wide and heavy loads. Due to the unique challenges posed by oversized and overweight cargo, this process involves detailed steps beyond standard freight routing.

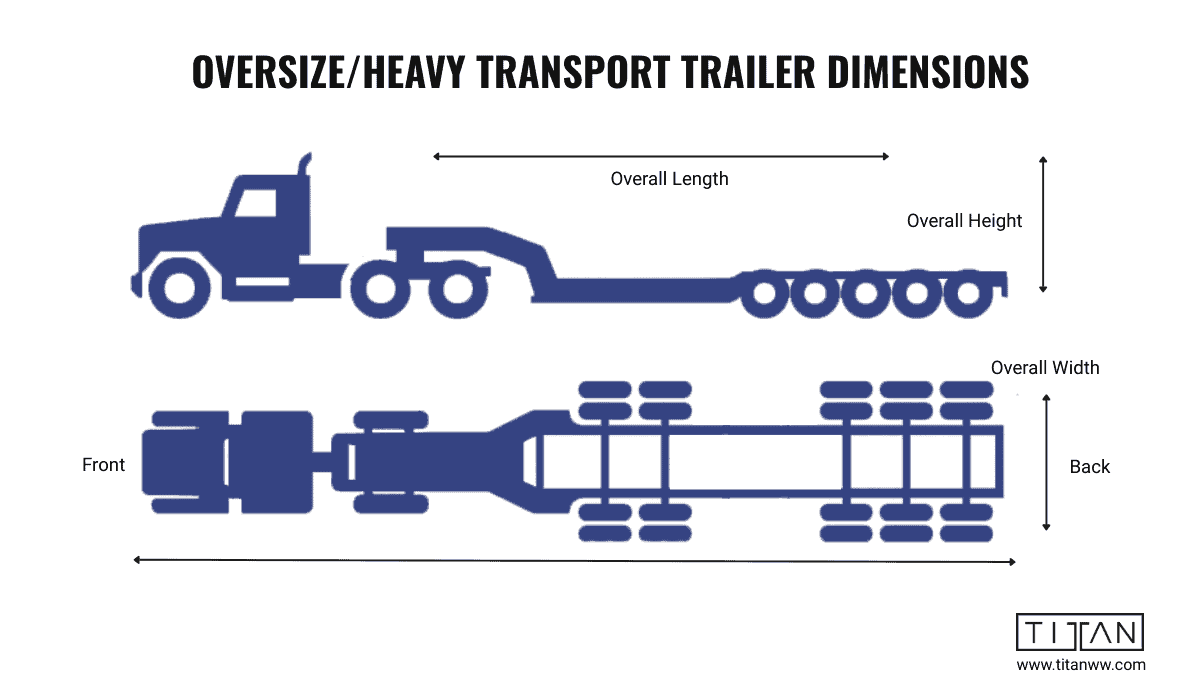

The illustration highlights the critical dimensions, including overall length, height, and width, measured on oversized configurations that must be verified before mapping a compliant route.

Figure 1. Dimensional reference for oversize/overweight haul units.

The following actions constitute the core of route planning:

Assess Load Dimensions and Equipment Needs

The process begins with precise measurements of the cargo’s length, width, height, and weight. These dimensions determine the required permits and influence the choice of equipment, such as trailers and securing devices. For example, crane support or custom securement systems may be necessary to stabilize the load for transport.

Identify Critical Route Constraints

Route planners must assess infrastructure along every potential path. They must check for limiting features such as low bridges, narrow lanes, sharp curves, weight-restricted or weak bridges, steep grades, and road surfaces that cannot support the load.

Account for operating conditions, such as traffic levels, local curfews, work zones, and seasonal restrictions (example, spring‑thaw bans) that can remove routes from consideration.

The U.S. DOT Grade Crossing Safety Task Force highlights a significant gap in many planning resources:

"Maps used to define special vehicle routes typically do not identify rail crossings, nor do they contain notations of crossings with high profiles or limited widths, storage space, or signal phasing times that could be problematic for vehicles that are extra wide, high, long, low or heavy. These crossing characteristics are usually not captured in State transportation agency inventories of physical infrastructure, and even when they are, they are generally not provided to or used by the agencies that issue special permits. Updating and maintaining this database, when it exists, constitutes additional problems."

Always verify rail grade crossings independently through agency contacts, field inspections, and current permits to prevent hidden constraints from derailing the route.

Conduct a Detailed Route Survey

Before any movement begins, the route must be verified end-to-end through a documented field and digital survey. This process confirms vertical and horizontal clearances, bridge and roadway limits, turning radii, temporary work zones, and permit restrictions, ensuring full regulatory compliance and operational safety.

The following equipment is standard for a defensible route survey. Ensure it is available, calibrated, and operated by trained personnel.

 Equipment CategoryPrimary Function
location pin map marker icon outlineUp-to-Date Maps and GPS DevicesState maps with restrictions plus onboard GPS for turn‑by‑turn routing
height measurement ruler icon with arrowsHeight PolePole on the escort vehicle to check the bridge/wire vertical clearance
measuring device, laster metersMeasuring DevicesTapes, laser meters, and clinometers to measure width, clearance, and grade
video camera camcorder icon outlineCameras and Video RecordersDash/still/video cameras to document obstacles, conditions, and hazards
two-way radio walkie talkie iconCommunication DevicesRadios and other comms for escort and survey team coordination

Infrastructure and Safety Considerations

Planners must consider vertical and horizontal clearances, weight limits on bridges and pavement strength, and the need for escort vehicles or warning signage.

Exceeding legal load limits places disproportionate stress on roads and bridges, accelerating deterioration and driving up repair and maintenance costs. Adhering to these guidelines minimizes risks to public safety and infrastructure.

Timing and Scheduling

Timing and scheduling are critical in transporting wide and heavy loads, impacting safety, efficiency, and regulatory compliance.

Oversized and overweight shipments require more precise timing considerations due to their potential to disrupt normal traffic flow and infrastructure limitations. One key aspect is scheduling transport during off-peak traffic hours to minimize congestion and reduce the risk of accidents.

According to the Federal Highway Administration (FHWA), scheduling trips during low traffic periods helps maintain smoother traffic flow and decreases hazards caused by large load movements during busy hours.

Contingency Plans

Preparing alternative routes and adjusting plans for unforeseen events such as road closures, traffic accidents, or adverse weather is vital. Having backup plans helps maintain smooth transport and reduces costly delays.

Case Study: Missouri Department of Transportation Oversized & Overweight Permit Regulations (2025)

Missouri’s 2025 Oversize/Overweight (OS/OW) Permit Regulation establishes a comprehensive and uniform permitting system for vehicles exceeding legal limits for length, width, height, and weight as set by state statutes.

Effective March 30, 2025, these regulations focus on safeguarding public safety, protecting infrastructure, and ensuring efficient movement of OS/OW loads throughout the Missouri state highway system.

Key Features and Findings

  • Uniform Permit System: Permits are required for OS/OW vehicles operating on state highways, applying to loads exceeding maximum legal size and weight limits detailed in Chapter 304 of the Missouri Revised Statutes.
  • Permit Conditions and Responsibilities: Permit holders assume full responsibility for personal injury, property damage, and any harm to state infrastructure caused during transport. Movement must adhere strictly to permit conditions, including routes, load dimensions, and travel times.
  • Financial Responsibility: Insurance coverage requirements vary by permit type, ranging from $750,000 for routine loads to $2 million for super heavy or large loads, ensuring state protection from potential damages.
  • Fee Structure:
    • Single-trip oversized permits start at $15.
    • Oversized loads exceeding 16 feet wide, 16 feet high, or 150 feet long incur a $250 movement feasibility fee.
    • Overweight permits include a base fee plus additional charges depending on the weight exceeding legal limits. They may also involve bridge and roadway analysis fees ranging from $425 to $925 based on trip length.
    • Annual blanket permits for various commodity types are available, with fees prorated quarterly.
  • Annual Blanket Permits: These permits simplify frequent movements of certain commodities such as farm implements, manufactured homes, and public utility equipment under specific dimension limitations. They require continuous insurance and license compliance.
  • Route Restrictions & Escort Requirements:
    • Travel is limited to daylight hours unless otherwise permitted, with strict prohibitions during hazardous conditions or specified holidays.
    • Specific escort vehicle requirements depend on load dimensions and weight, ranging from one or two civilian escorts for overlength or overwidth loads to law enforcement escorts for superloads. Height detection escort vehicles are mandated for loads exceeding 15 feet 6 inches.
    • Escort vehicles must be adequately equipped and licensed, and standardized signage and flags must be displayed to alert other traffic.
  • Safety and Compliance Focus: The regulations prioritize safety over economics in route selection, allowing MoDOT to designate routes based on structural capacity, roadway width, and traffic volume. Non-compliance with permit terms can result in revocation, fines, or denial of future permits.
  • Special Provisions: Emergency moves, noncommercial building transportation, and superloads have additional rules to address their unique challenges, including greater insurance, escort, and route planning requirements.

Practical Implications

Missouri’s OS/OW permit regulations represent a thorough and state-specific approach to managing oversized and overweight vehicle movements, balancing the needs of commerce and infrastructure preservation.

The detailed fee structures, route restrictions, and safety commitments reflect a mature permitting system designed to minimize roadway damage, ensure public safety, and clarify carriers’ responsibilities.

The annual blanket permit options accommodate frequent shippers and recurring loads, improving operational efficiency while maintaining oversight. Escort requirements tailored by load characteristics ensure proper traffic management during oversized moves, reducing hazards and improving roadway conditions for all users.

This regulation serves as a robust example of how a central U.S. state structures its OS/OW permitting to align with legal statutes, enforce safety, and accommodate industry needs through clarity and comprehensive regulation.

Safer Heavy Haul Compliance

This guide has underscored the critical distinctions between divisible and nondivisible loads, the mandatory role of escort vehicles, and the necessity for meticulous route planning to mitigate infrastructure risk and enhance safety.

The decentralized nature of permit issuance across states and the increasing adoption of automated permitting platforms highlight the evolving operational environment. To maintain regulatory compliance and operational efficiency, stakeholders must remain vigilant of variable escort requirements, dynamic route constraints, and timing considerations.

Ultimately, a strategic approach grounded in adherence to legal thresholds, detailed pre-movement assessments, and contingency planning is indispensable for successful oversized and overweight transport.

Mastery of these elements ensures smoother logistics, safeguards public infrastructure, and enhances highway safety, supporting the continued mobility of critical oversized cargo nationwide.

References

Best Practices in Permitting Oversized and Overweight Vehicles. (n.d.). U.S. Department of Transportation Federal Highway Administration.
https://ops.fhwa.dot.gov/publications/fhwahop17061/fhwahop17061.pdf

Caltrans – Transportation Permits (Oversize/Overwei
ght Vehicles) | Caltrans
. (n.d.). Caltrans.
https://dot.ca.gov/programs/traffic-operations/transportation-permits

Commercial Driver License Classes. (n.d.). TN.gov.
https://www.tn.gov/safety/driver-services/commercial-driver-license.html

Federal Motor Carrier Safety Regulations. (2024, November 18). Federal Register.
https://www.federalregister.gov/documents/2024/11/18/2024-25514/federal-motor-carrier-safety-regulations

49 CFR Chapter I Subchapter C — Hazardous Materials Regulations. (n.d.). eCFR.
https://www.ecfr.gov/current/title-49/subtitle-B/chapter-I/subchapter-C

Large Trucks – Injury Facts. (n.d.). Injury Facts. Retrieved September 15, 2025, from
https://injuryfacts.nsc.org/motor-vehicle/road-users/large-trucks/

Monthly or Annual Non-Divisible Permit. (2022, March 1). ORIA.wa.gov.
https://www.oria.wa.gov/site/alias__oria/mid__12357/403/handbook-entry?ItemID=182

Oversize/Overweight Load Permits – FHWA Freight Management and Operations. (2025, July 1). FHWA Operations.
https://ops.fhwa.dot.gov/freight/sw/permit_report/index.htm

Oversize/Overweight Permit Regulations. (n.d.). Missouri Department of Transportation.
https://www.modot.org/sites/default/files/documents/2025%20OSOW%20reg%20book%20Final.pdf

Pilot/escort vehicle and operator requirements. (n.d.). Washington State Legislature.
https://app.leg.wa.gov/wac/default.aspx?cite=468-38-100

Pilot/Escort Vehicle Operators Training Manual – MODULE 3: Route Planning – FHWA Freight Management and Operations. (2020, April 30). FHWA Operations.
https://ops.fhwa.dot.gov/publications/fhwahop16050/m3.htm

Transportation. (2024, October 22). Utah Office of Administrative Rules.
https://adminrules.utah.gov/public/rule/R909-2/Current%20Rules?searchText=909-2-1#
